A panel upgrade in a New York City usually means moving from a 60 or 100-amp service to 200 amps, or replacing a full or obsolete panel with a new one with room to grow. Angi's New York data puts 200-amp service installation at roughly $1,465 to $2,250, and the job needs a DOB electrical permit and inspection.
Updated September 2026
The panel is where everything you plug in meets the service the building gives you. When both date from the 1960s and the apartment now runs an induction range, a heat pump and two window units, breakers trip and lights sag. The fix is a load calculation first, then a panel sized to the load.
In a house the upgrade is mostly ours to do. In a co-op or condo it's a three-way job: you, the building, and sometimes Con Edison, because a bigger panel is useless if the riser feeding it is undersized. We check the riser and the meter before quoting, so the number you get is for the whole path.
We install Square D and Eaton panels and hand you a labeled directory and the inspection sign-off.

Same-size swap or a service upgrade?
| Option | When it fits | What's involved |
|---|---|---|
| Same-amperage panel swap | Obsolete or full panel, service already adequate | New panel and breakers, same feeder, DOB permit |
| 100A to 200A upgrade | Charger, heat pump or range being added; load calculation over 100A | New panel, main and service conductor; Con Edison may pull the meter |
| Panel plus subpanel | Long runs to a kitchen or basement, main panel full | Main panel kept or replaced, feeder to a new subpanel |

100-amp to 200-amp upgrades
Going from 100 to 200 amps means a new panel, a new main breaker, and often a larger service conductor from the meter. In a one- or two-family house the conductor run is short and the job is usually a day. In an apartment building the feeder from the meter room can be long and shared, so we check its size before promising 200 amps; sometimes the honest answer is 150. The permit is filed in DOB NOW, Con Edison is scheduled if the service has to be pulled, and inspection follows.
$1,500 to $4,000 all-in; older buildings needing a service entrance upgrade $3,500 to $6,000. Source: aecontractorsnyc.com, 2026-09. Published market range for budgeting only, not our quote.

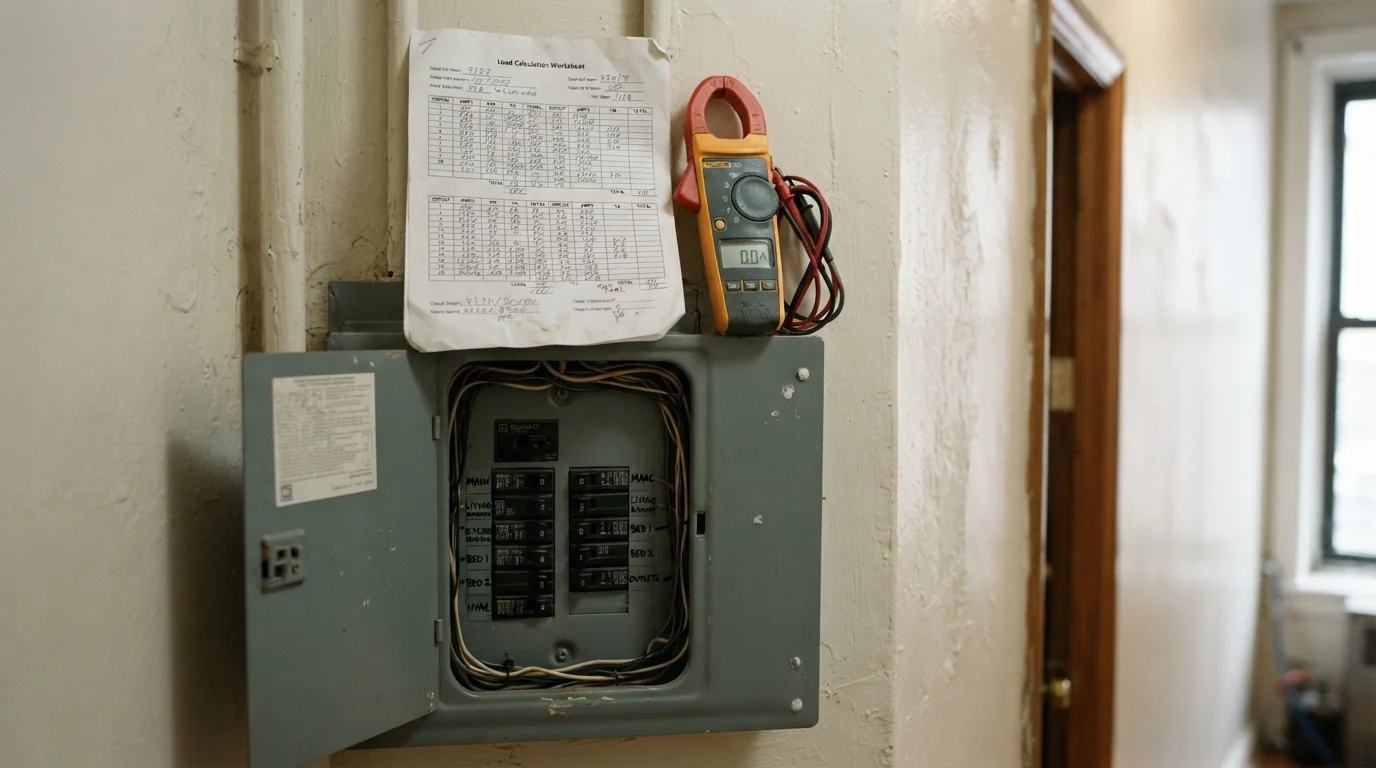

Load calculation for new equipment
A load calculation adds up what the space actually draws: lighting and general receptacles by square footage, the kitchen circuits, fixed appliances, HVAC, and any charger or heat pump you're planning. The number tells you whether the existing service can carry the new load or whether the panel is only half the answer. Co-op and condo boards ask for this as a load letter before they approve an alteration, and we prepare it as part of the estimate rather than as a separate visit.
Panel relocation
Panels in closets, bathrooms and behind refrigerators fail code and inspection. Moving one means extending every branch circuit to the new location, which in plaster-and-lath walls is careful work. We plan the route with the fewest openings, use armored cable throughout, patch as we go, and rebuild the wall only where we had to open it. Relocation adds labor to a straightforward upgrade, so we'll tell you when the existing spot can stay and when the inspector won't sign off on it.
Federal Pacific and Zinsco panel replacement
Federal Pacific Stab-Lok and Zinsco panels have a documented history of breakers that fail to trip under fault. If your panel carries either name, replacement is the recommendation regardless of how it's behaving today. The swap is a like-for-like amperage change with new breakers, new bus and new grounding, and it's a good moment to add AFCI and GFCI protection where the 2025 code now requires it. Insurers and co-op boards increasingly ask for this before approving renovations, and the panel label tells you which brand you have.

What moves the price
- Amperage: a 200-amp service costs more than a same-size panel swap
- Length and size of the service conductor from the meter
- Whether Con Edison has to disconnect or upgrade the service
- Panel brand, breaker count and AFCI or GFCI breakers required
- Relocation, with branch circuits extended to the new spot
- Plaster, lath and finished-wall repair
- DOB filing and inspection fees
$1,465 to $2,250 to install 200-amp service; average panel upgrade $1,802, most paying $1,351 to $2,252. Source: www.angi.com, 2026-07-09. Published market range for budgeting only, not our quote.
What a panel upgrade includes
- Load calculation and load letter for the building
- Permit filed in DOB NOW before work starts
- New panel with copper bus and full-size spaces
- New main breaker sized to the service
- Every branch circuit landed and torqued to spec
- AFCI and GFCI breakers where the 2025 code requires them
- Grounding and bonding brought to current code
- Typed circuit directory on the panel door
- DOB inspection scheduled and attended

What we see in New York buildings
In Manhattan nearly all housing units, about 97 percent, sit in buildings of six or more units, so a panel upgrade there is rarely just a panel. The feeder from the meter room, the building's riser capacity and the alteration agreement all come into it, and a load letter is usually the first thing the board wants. A hardwired Level 2 charger is the most common reason people call: it needs a 240V circuit with spare capacity, and many apartments need the panel upgrade before the charger can go in.
What happens after you call
- 1
Load calculation and site check
We add up the real load and look at the riser, meter and existing panel before quoting.
- 2
Written scope
Amperage, panel model, breaker schedule and whether Con Edison is involved, in writing.
- 3
Permit filed
The electrical permit goes into DOB NOW before the old panel comes off the wall.
- 4
Panel installed
Power off, new panel and main set, every circuit landed, labeled and tested.
- 5
Inspection and sign-off
We meet the DOB inspector and hand you the sign-off and the circuit directory.
Brands we install and service include Square D and Eaton panels, Leviton and Lutron devices, and Tesla and ChargePoint chargers.
Questions about electrical panel upgrade in New York
Not always. A load calculation tells us. Many apartments are fine at 100 or 150 amps with a new panel; houses adding a charger and heat pump usually need 200.
Yes. It's a DOB electrical permit with an inspection, filed with the DOB. We file it before the work starts.
Usually a few hours for a same-location swap. A service upgrade that needs Con Edison to pull the meter can take longer, and we schedule that with you.
They can require a load letter and set work hours. We supply the paperwork and work inside the building's rules.
Square D and Eaton, with copper bus and full-size breaker spaces. Both have breakers stocked everywhere in the city.
Its breakers have a documented failure history. We recommend replacement even if it hasn't given you trouble.
